CERP Picayune Strand (C)

May 2024

FACT SHEET

COMPREHENSIVE EVERGLADES RESTORATION PLAN
Picayune Strand Restoration

Construction (C)
Congressional Districts: 19, 26

1. DESCRIPTION

Congress authorized the Picayune Strand Restoration Project in the Water Resources Development Act (WRDA) of 2007 and amended the authorization in the Water Infrastructure Improvements for the Nation Act (WIIN) of 2016. The purpose of the project is to restore and enhance the wetlands back to pre-development hydrology. The project is located in Collier County, south of I-75 and north of U.S. Highway 41 between the Belle Meade Area and the Fakahatchee Strand State Preserve. Implementing the project will improve the water quality of coastal estuaries by moderating the large salinity fluctuations caused by freshwater point discharge from the Faka Union Canal. The project will aid in protecting the City of Naples’ eastern Golden Gate wellfield by improving groundwater recharge, as well as help replenish the aquifer system. The project includes a combination of pump stations, spreader basins, protection levee, manatee refugia, canal plugs, and road removal.

2. FUNDING

Estimated Total Cost $681,447,000
Estimated Federal Cost $302,638,500
Other Federal Agency $38,085,000
Allocation thru FY23 $406,924,515
Allocation for FY24  $7,700,000
President's Budget FY25                $10,000,000



3. SPONSOR

South Florida Water Management District (SFWMD)
3301 Gun Club Road
West Palm Beach, Florida 33406

4. STATUS

The South Florida Water Management District (SFWMD) initiated construction of the Picayune Strand Restoration project by plugging the Prairie Canal as part of the SFWMD Expedited Construction Plan. This effort also included the design for Merritt, Faka Union, and Miller pump stations. The Project Partnership Agreement (PPA) was executed in August 2009.

The U.S. Army Corps of Engineers (Corps) awarded the Merritt Pump Station and Road Removal construction contract in October 2009. Pump station construction and road removal were completed in September 2014 and the facility was transferred to SFWMD in June 2016.

The Corps awarded the Faka Union Pump Station and Road Removal construction contract in November 2010. Construction was completed in January 2016 and the facility was transferred to SFWMD in January 2018.

The Corps awarded the Miller Pump Station construction contract in September 2013. Construction was completed in May 2018 and the facility was transferred to SFWMD in March 2020.

SFWMD constructed the Manatee Mitigation Feature (Manatee Refugia) to mitigate for the effect of the project on manatees in the Faka Union Canal. Construction was completed in April 2016. In June 2019, the Corps and SFWMD executed a PPA Amendment to grant SFWMD the authority to request credit for this feature.

In October 2017, SFWMD requested that the Corps take over design and construction of all remaining features of the project. The Corps completed design of the Southwest Protection Features—a 7.2-mile levee between the Picayune Strand Project site and the agricultural land southwest of project site; and culverts under US Highway 41 and County Road 92 in Collier County—in 2020. The levee will provide protection to the agricultural area from the restoration of the hydrology and the culverts will provide additional conveyance through the roads. Construction contracts for the levee and culverts were awarded in September 2020 and the work is scheduled for completion in December 2024.

Road removal north of the tie-back levee is complete. The contract for Miller Tram and Road Removal west of Miller Canal was awarded in September 2019 and was completed in September 2023 The eastern Stair Step Canal plugging is complete.

Clearing and plugging of the upper 3.3 miles of the Faka Union Canal began in January 2021 and was completed in July 2022. This work was completed ahead of schedule and has facilitated the realization of benefits in the northern portions of the project. The remaining portion of the Faka Union Canal will be completed in June 2024.

After the Southwest Protection Features are constructed, the Miller canal can be plugged, and full hydrologic restoration can be realized. This is anticipated in late 2025.

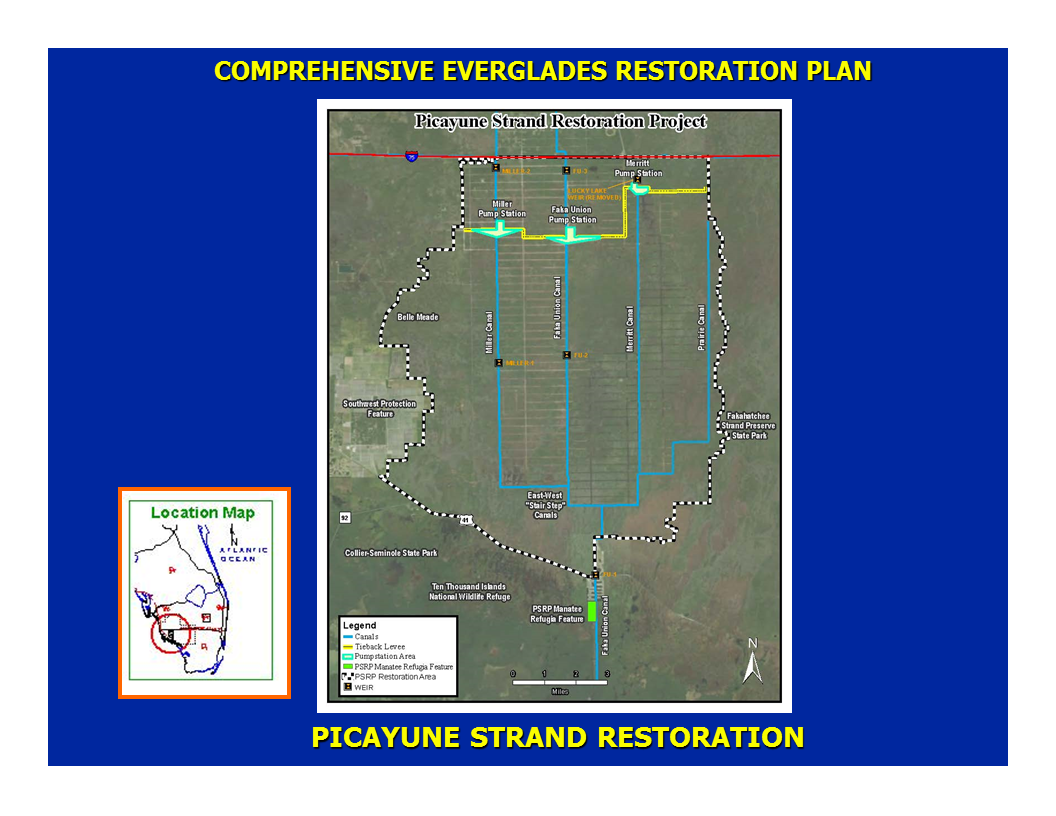

Click to see full-size map of PSRP project area
